road
- Details
- Written by Bob Allan
- Category: road
- Hits: 832
Road work January 2023
Thanks to all who contriuted both during 2021 and 2022 and those who responded to our note in December 2022.
We did some work on the road in January 2023.
Spread 34 loads of gravel, level and pack with an excavator.
Here is a link to a driving tour over the road showing the new (coarse gravel) sections.
Driving tour of the road January 2023.
Hey folks;
December, 2022
Dear New Elm Lot Owners;
Hoping this note finds everyone well.
A brief update about our road since September 2021.
Our most recent road work was in 2020. We intended to do some significant work this year (2022) but did not do so yet. Ian is coordinating some work now and so we are sending a quick update and offering opportunity to contribute and increase the amount of work we can get done. Recognize this is short notice and a short note; three of us have already promised to contribute immediately; we have some cost advantage because the contractor has equipment on-site on another job.
The beaver battle continues and the pond is over-flowing the road once again. We are looking at options including a renewed culvert and road work and perhaps some re-location service for the beavers. We expect to do something about the beaver and overflow of the road also before it freezes up.
Our historical annual contribution of $400 or biannual (double) contribution of $800 per lot per year has enabled the work done so far. We can put a double contribution to good use this fall if you are able to contribute; every bit helps. We plan to fill pot-holes on the newer sections with gravel then begin at the outer end of the new sections and run until the money runs out.
Please tell Ian or Bob when you deposit in our account just so we can keep track of who contributed because the bank statement doesn't say. We keep all un-spent contributions in the bank ($5,089.34 today) which neither earns interest nor incurs fees. There are now 16 of us owning 18 lots between us. We are all in this together and voluntarily.
Bank account remains the same as last time:
Scotiabank: LAHAVE STREET, PO BOX 400 BRIDGEWATER NOVA SCOTIA B4V 2X6
Your account number: 71613 04928 25
Account holder: Robert Allan and Ian Goldsmith (ITF New Elm Estates Lot Owners Road).
Reporting our contribution and costs for 2022 to date:
2021-09-03 Open |
$1,189.34 |
2021/2022 contributions to date |
$3,900.00 |
2021/2022 Costs |
$0.00 |
2022-12-19 Balance |
$5,089.34 |
Note: Bob loan remaining $2400 (reduce by $800 contribution 2022) |
As always, we’re in it together so please tell us your suggestions on how or what we should do together.
Bob Allan and Ian Goldsmith
Bob Allan cell: 902-497-9674 Ian Goldsmith cell 902 521-5552
- Details
- Written by Bob Allan
- Category: road
- Hits: 781
September, 2021
Dear New Elm Lot Owners;
Hoping this note finds everyone well. This note brings an update about our road since June 2020.
Last year’s (2020) work finished the gap around the hill and the new road surface is continuous. We seem to have won our beaver battle and the pond has not over-flowed the road since last spring. Last year (2020 summer) we over-spent our bank for that stretch around the hill and Bob loaned $3200. to the road to cover that; we’ll catch that up over the next couple of years.
This year we did not plan any major road work. For those who contribute annually we will appreciate your contributions this year of course. Our historical annual contribution of $400. or biannual (double) contribution of $800. per lot per year has enabled the work done so far. We are looking forward to a double contribution year next year and planning to begin at the outer end of the new sections and run until the money runs out.
Our voluntary arrangement has worked well. Some have asked about contributing for this year and at least one person has already. Please tell Ian or Bob when you deposit in our account just so we can keep track of who contributed because the bank statement doesn't say. We keep all un-spent contributions in the bank ($1189.34 today) which neither earns interest nor incurs fees. There are now 16 of us owning 17 lots between us. We are all in this together and voluntarily.
Bank account is the same as last time (2018):
Scotiabank: LAHAVE STREET, PO BOX 400 BRIDGEWATER NOVA SCOTIA B4V 2X6
Your account number: 71613 04928 25
Account holder: Robert Allan and Ian Goldsmith (ITF New Elm Estates Lot Owners Road).
Reporting our contribution and costs for 2020 and 2021 to date:
2020 Open Balance |
$729.93 |
2020 Contribution |
$9,906.40 |
2020 Loan (Bob) |
$3,200.00 |
2020 Costs |
-$12,946.99 |
2020 Close Balance |
$889.34 |
And for 2021 to Date |
|
2021 Open Balance |
$889.34 |
2021 Contribution to Date |
$300.00 |
2021-09-03 Balance |
$1,189.34 |
Finally, you may have noticed some new shale on the inner most end of the New Elm Estates Road and on down toward Mint Brook. I know Bob told some who asked that we weren’t doing anything on the road this year, but that little project sort of grew from a couple loads of gravel in the potholes to a larger job. That work was done at cost shared by six of the folks along that stretch, five sharing the $2450. for the shale and Ian Goldsmith on the mini excavator. Thanks to all those folks for their extra effort.
As always, we’re in it together so please tell us your suggestions on how or what we should do together.
Bob Allan and Ian Goldsmith
- Details
- Written by Bob Allan
- Category: road
- Hits: 776
Date: 2020-06-12
New Elm Estates Drive road maintenance future cost estimates
Work done:
• About 1.9 km of Shale base and Class A topped road built
◦ about 1.45 km of that re-coated with Class A in 2016
◦ moving the road sideways at the hill (2014) with lots of shale needed
• Large culvert and beaver excluder installed which dried up the inner beaver pond (2016)
• Spot filling of pot holes with shale in several places neither included in the distance covered.
• Historical cost of shale-base gravel-top is about $20. per linear metre of road on the last couple of large jobs; typically constructed as:
◦ 14 foot wide road
◦ 4 to 5 inches thick shale on average (Shale is $150 / 10 cu yd load historically)
◦ 3/4” to 1.5” thick gravel over-top (gravel is $20./ton as laid historically)
◦ Over-top with 1” at 14 ft wide costs $4.67/m. (maintenance)
Work remaining and build alternatives:

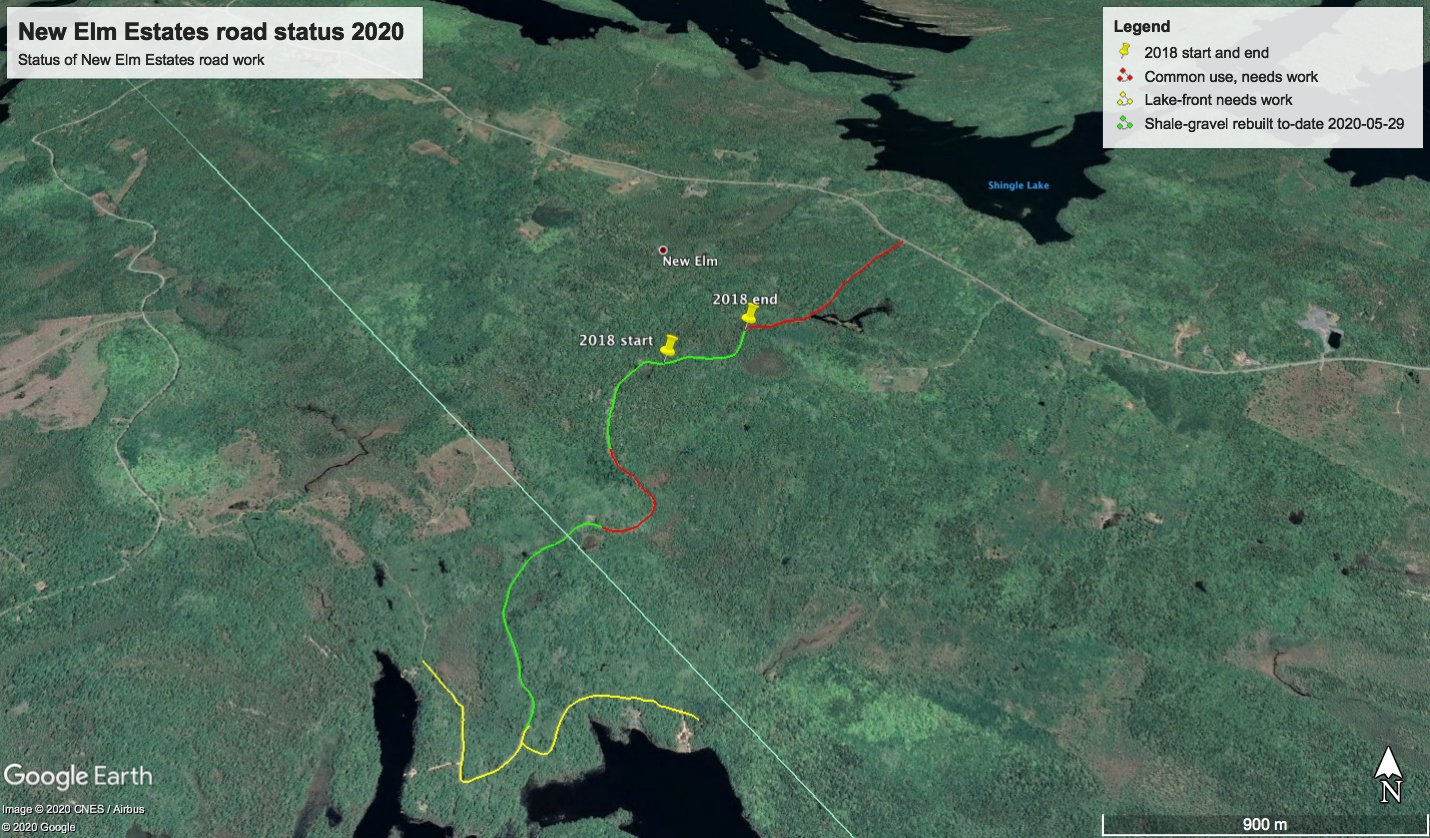

Remaining 2.9 km of road including all of Long Cove and Mint Brook to the end of all developed lots and the remainder of New Elm Estates Drive to Mint Brook, the gap at the hill, and out bound past the beaver pond to the highway. See the list in Table 1 and map in Figure 1.
Historical build uses 4.5” shale and 1.5” Class A gravel plus the machine time which has been about 15 percent of the shale cost. The road requires periodic over-top coating with Class C to maintain cover and smoothness. Can’t smooth this with a grader because of the shale base.
An alternative using Class C gravel in place of the shale would reduce the machine time at the expense of material for the base and allows a grader to maintain smoothness and spot-filling with gravel. Estimate with same thickness of of Class C as shale and same thickness of Class A and reduce the equipment burden to 2/3. The gravel road build estimate is about $29./m at current gravel prices. Alternatively, using only three inches of Class C gravel without shale or Class A is a half-step to get a good-enough road quality at a reduced cost of $15./m
Section | Distance (m) | Shale road, historical ($) | Gravel Road, Estimate ($) | Gravel (3”) only Estimate ($) |
Hill gap completion | 550 | $11,000.00 | $16,002.00 | $8,302.76 |
Inner to Mint Brook | 283 | $5,660.00 | $8,234.00 | $4,272.00 |
Mint Brook to Lot 2 | 460 | $9,200.00 | $13,379.00 | $6,939.77 |
Outer part 1, to beaver pond | 306 | $6,120.00 | $8,911.00 | $4,627.78 |
Outer part 2, beaver pond to highway | 640 | $12,800.00 | $18,624.00 | $9,665.75 |
Long Cove part 1 | 446 | $8,920.00 | $12,970.00 | $6,726.69 |
Long Cove part 2 | 225 | $4,500.00 | $6,542.00 | $3,391.50 |
The beaver pond culvert installation will require a culvert (~$550.) plus a load of gravel (~$350.) plus machine time which Ian Goldsmith can contribute. (estimate $1,000. materials plus Ian’s effort)
The section of road built in 2018 needs an over-top with Class A. That section had thinner gravel top when-built (to stretch the budget). We have had enough traffic to wear-through to shale proving we need the planned thickness. Estimate this work at $2,000. for the 1” cover on the 14 foot width.
Ian Goldsmith will be doing some pot hole filling with his equipment and a couple of loads of material that he is contributing beginning weed of 22nd June, 2020. That will help a lot.
Colour coded segments show green (done), red (to-do urgent), and yellow (to-do less urgent)
- Details
- Written by Bob Allan
- Category: road
- Hits: 708
New Elm Estates Drive road maintenance summary August 2018 through May 2020
Date: 2020-06-12
Our most recent update on the road maintenance was back in August, 2018. We outlined some plans for work by contract to Darrell Naugler and by way of contribution by Ian Goldsmith. We followed that plan and report a few highlights:
Darrell’s work: Shale with Class A build over the outbound section from the end of 2016 work for a distance of about 430 metres (470 yards) at a cost of $19.66/metre ($16.90/yd)
Item |
Amount |
Cost |
Class A Gravel |
62.69 Tons |
$1,247.20 |
Shale |
31 loads |
$5,115.00 |
Machine Time (mini excavator) |
10.5 hours |
$787.50 |
Machine time (moving it around) |
1 lot |
$200.00 |
Subtotal |
|
$7,349.70 |
Tax (HST) |
|
$1,102.46 |
Total |
|
$8,452.16 |
Ian’s work: Concentrated on the gap section between the hill and the pit. This is in lieu of Goldsmith’s (Lot 2) cash contribution for the 2018 year.
- Mini-excavator ditching in the section around the hill, rock picking and smoothing the road.
- Supplied and installed a culvert ($350.) c/w a load of shale ($300.) at the low point in the gap draining the up-hill side ditch and pond.
- Supplied and installed a culvert replacing the wooden one on outbound side of the low point. You may notice this still needs a little fill. The rut is because the old wooden work failed again after placing a culvert underneath it.
- Supplied and installed a culvert at the wet spot where we had only clear-stone for drainage before. Ran a ditch off into the down-stream side and re-filled with the existing stone.
- Drained several puddles including a notch in the down-stream side of the road at the beaver pond.
Short summary of all work to date over the many years:
- About 1.9 km of Shale base and Class A topped road built
- about 1.45 km of that re-coated with Class A in 2016
- moving the road sideways at the hill (2014) with lots of shale and a culvert needed
- Large culvert and beaver excluder installed which dried up the inner beaver pond (2016)
- Spot filling of pot holes with shale in several places neither included in the distance covered.
Remaining work to do:
A remaining 2.9 km of road has not been rebuilt including the remainder of New Elm Estates Drive consisting of the gap at the base of the hill and out bound sections to the highway (~1.5 km) and the lake-front section of New Elm Estates Drive to Mint Brook plus Mint Brook and all of Long Cove to the end of all developed lots (~1.4 km).
Page 1 of 3
